The Ixonia LNG facility will be located in Jefferson County, Wisconsin in the town of Ixonia. The plant will be located approximately 5.7 miles southeast of the city of Watertown, Wisconsin and approximately 3.3 miles northwest of the city of Oconomowoc, Wisconsin.
The project includes a new LNG peaking facility, associated on-site pipelines and supporting equipment. The facility will be capable of liquefying, storing and vaporizing natural gas for peaking service.
Key project dates
Activity |
Time frame |
Construction start |
January 2022 |
Impoundment construction start |
March 2022 |
Tank foundation poured |
May 2022 |
Tank construction complete and commissioning begins |
Fall 2023 |
May 2022 — project update
Despite a cold and rainy spring, construction of the Ixonia LNG plant remains on schedule.
Crews pouring concrete
Overhead view of crews pouring concrete

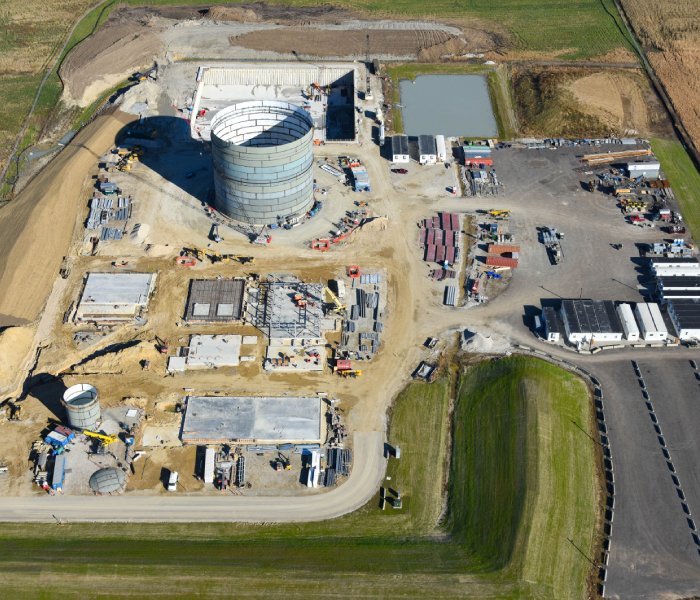

Ixonia LNG tank foundation
Crews are pouring concrete for the LNG tank foundation. Approximately 800 yards of concrete has been brought in by
truck from plants in Watertown and Whitewater. The trucks unload into the two red pumper trucks. Aerial booms connected
to the trucks bring the concrete to the foundation. Workers use vibrating equipment to move the concrete in between the
foundation rebar. Once this work is done, crews will begin putting up the carbon steel outer tank.
Core project (on-site) work hours
Monday to Friday
7 a.m. to 5 p.m.
Saturday* 7 a.m. to 5 p.m.
Sunday* 10 a.m. to 5 p.m.
*Only as necessary
Typical delivery hours
Monday to Friday
8 a.m. to 2:30 p.m.
